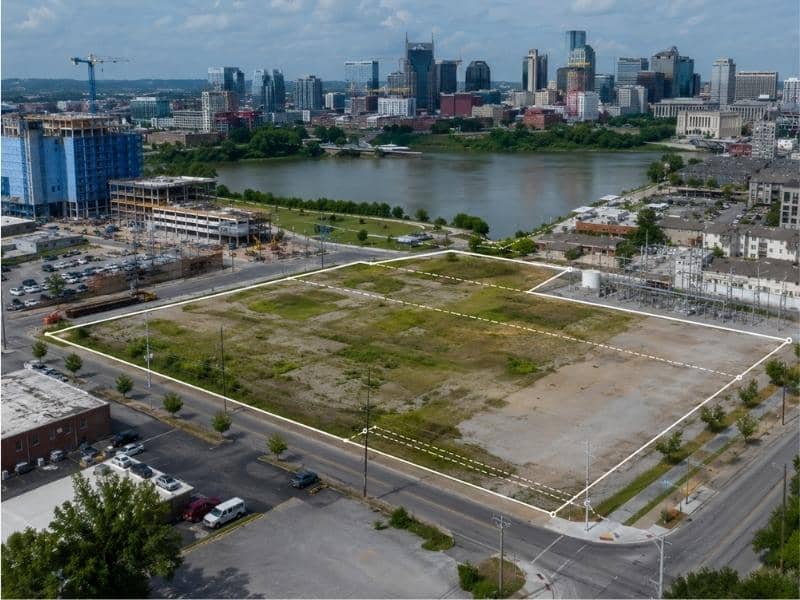

What a Nashville ALTA Survey Can Reveal Before East Bank Property Acquisition

An ALTA survey turns a purchase decision from a hopeful one into an informed one. Redevelopment property in a changing district looks straightforward on a listing sheet. The reality underneath tends to be layered. Old deeds describe parcels that were split and reassembled over generations. Utility corridors cross ground the buyer plans to build on. Streets around the site may be scheduled to move. An ALTA survey pulls all of that into one drawing tied to the title commitment, which is what a buyer needs before the money moves.
Reconstructing the Legal Limits of a Redevelopment Parcel
The survey starts with the paper trail. The surveyor works from the title commitment, the current deed, prior deeds, recorded plats and any right-of-way documents affecting the property. Older industrial and commercial districts often produce a thick file, since parcels there changed hands repeatedly.
Descriptions from different eras rarely agree perfectly. One deed may reference a rail line that’s gone. Another may describe a line running to a street that’s been widened twice. The surveyor traces each call, decides which evidence carries the most weight, and reconstructs the boundary from the strongest available proof.
Fieldwork tests the conclusion. Crews search for monuments, measure adjoining improvements and compare occupation against the record. Where the two disagree, the survey shows both. That difference can affect the buildable area, so a buyer needs to see it before closing rather than after.
Showing Utility Corridors That May Restrict New Construction
Utility corridors quietly remove development areas. A sewer trunk line, a water transmission main, a gas line or an electric transmission corridor can cross a site inside a recorded easement. Building over one is usually prohibited, and relocating one is expensive and slow.
The survey plots each recorded easement from the document itself. Width, position and any stated restrictions all get shown. Crews then locate the physical evidence in the field, including manholes, valve boxes, markers, vaults and poles. Comparing the two reveals whether the installed line actually sits inside its easement.
Unrecorded lines create a different problem. A pipe crossing the property with no easement of record still exists, and it still has to be dealt with before construction. Showing it on the survey lets the buyer raise the question during due diligence, when there’s still leverage to address it.
Documenting Flood-Related Features and Existing Ground Conditions
Flood information belongs on the survey when the buyer requests it. That typically means showing the mapped flood zone boundaries, the panel reference and the base flood elevation, along with enough ground elevations to see how the site sits relative to those numbers.
Existing conditions fill in the rest. Crews collect spot elevations across the property, locate drainage structures, and measure the finished floor elevations of any buildings that will remain. Those numbers tell a design team how much fill a project needs and whether a ground-floor use is realistic.
Nearby features matter too. Floodwalls, levees, outfalls and channels close to the property affect what can be built and what protections apply. Locating them gives the engineer a starting point rather than a research assignment.
Confirming Access Before the Street Network Changes
Access needs verification, not assumption. A property that fronts a street today may rely on a right that isn’t as solid as it appears. The survey confirms whether frontage is on a public right of way, and it locates the boundary of that right of way as recorded rather than as paved.
Planned street changes deserve a hard look during due diligence. In districts under redevelopment, agencies often record plans and acquisitions well before construction begins. A survey that identifies a proposed right-of-way line crossing the property tells a buyer that part of what they’re purchasing may not stay theirs.
Recorded access rights get plotted alongside. Cross-access agreements, driveway easements and shared entrances all appear on the drawing with their limits shown. Where a site depends on a neighbor’s driveway, the buyer needs to know whether that dependence is documented or just habitual.
Matching Table A Requests to the Buyer’s Development Plan
Table A items are optional additions to a standard ALTA survey, and choosing them is a decision, not a formality. A buyer planning to hold the property makes different choices than one planning to break ground in a year. The lender, title company, attorney and design team all have input, and the request should be settled before fieldwork starts.
Development plans point toward specific items. A project that needs financing usually needs flood zone information. A project with structured parking wants building height and improvement locations. A site with existing tenants needs parking counts. A redevelopment that will relocate services needs utility evidence gathered from records and field markings.
Scope drives cost and schedule directly. Adding items after the crew leaves means a return trip and a revised drawing. Deciding early keeps the survey off the critical path, which matters when a closing date is already set.
Frequently Asked Questions
Can an ALTA survey be updated as redevelopment plans change?
Yes. Surveys get updated regularly as designs evolve, tenants change or new documents surface. An update typically involves reviewing a current title commitment, returning to the field for anything that changed, and reissuing the drawing with a new date. That costs far less than commissioning a new survey.
Which Table A items are most useful for a major redevelopment purchase?
It depends on the plan, but flood zone information, utility evidence, improvement locations and offsite easement details tend to matter most. Buyers planning near-term construction usually add elevation data. Discussing the list with the lender, title company and design team before fieldwork produces a better result than picking from the form alone.
How early should the survey begin before a commercial closing?
Earlier than most buyers expect. A complex parcel can take several weeks between record research, fieldwork and drafting, and revisions add more. Starting once the title commitment arrives leaves room to address anything the survey uncovers while the deal still has room to move.
